The next wave of Stabroek Block projects offshore Guyana

Must Read

OilNOW
OilNOW
OilNOW is an online-based Information and Resource Centre

ExxonMobil is moving ahead with its next set of developments in the Stabroek Block offshore Guyana, with Uaru, Whiptail and Hammerhead approved and progressing toward startup between 2026 and 2029, while Longtail remains in the planning stage as the company’s first proposed gas and condensate project in the basin.

About the developments:

Uaru will be ExxonMobil’s fifth development offshore Guyana. It is designed to add 250,000 barrels per day to national output once online.

Uaru (approved)

• Fields: Uaru, Mako, Snoek

• Resource: 800 million barrels of oil

• Development wells: 40 – 76

• First oil: 2026 (expected)

• Production capacity: 250,000 barrels per day

• FPSO storage: 2 million barrels

• Estimated cost: US$12.7 billion

MODEC’s M350 hull will be utilised for Exxon’s fifth Guyana project.

Whiptail will be ExxonMobil’s sixth development in the block. It mirrors the 250,000 barrel-per-day design used in recent projects.

Whiptail (approved)

• Fields: Whiptail, Pinktail, Tilapia

• Resource: 850 million barrels of oil

• Development wells: 33 – 72

• First oil: late 2027 – early 2028

• Production capacity: 250,000 barrels per day

• FPSO storage: 2 million barrels

• Offloading: approximately every 3 – 6 days

• Estimated cost: US$12.7 billion

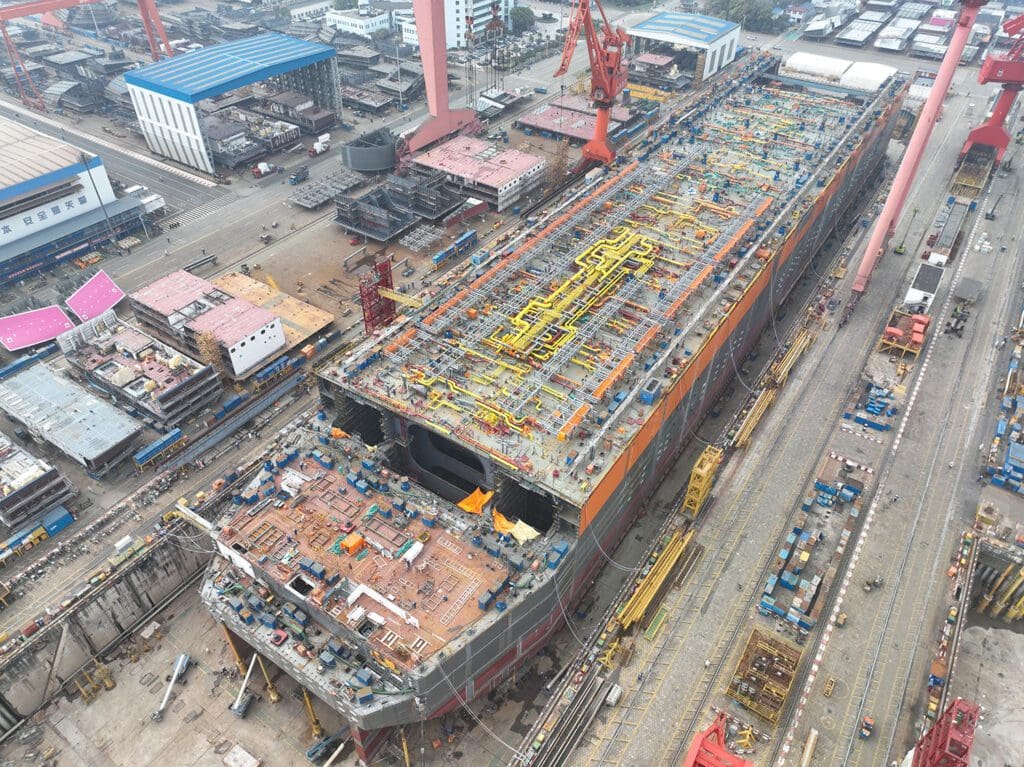

Construction of the Jaguar floating production, storage and offloading vessel is underway by SBM Offshore for ExxonMobil’s Whiptail Development Project in Guyana.

Hammerhead will be the seventh development. It carries a lower production capacity than Uaru and Whiptail but continues the phased buildout of the block.

Hammerhead (approved)

• Field: Hammerhead

• Development wells: 14 – 30

• First oil: 2029

• Production capacity: 150,000 barrels per day

• FPSO storage: 1.4 million barrels

Named after the Hammerhead shark, Exxon’s seventh Guyana project will tap its ninth Stabroek Block discovery.

Longtail is designed as a gas and condensate project. It will prioritize liquids recovery while re-injecting most of the gas in its early years to maintain reservoir pressure and maximize condensate output. The project is expected to rely entirely on gas recycling instead of water injection, with twice the gas compression capacity of previous floating production, storage and offloading vessels.

Longtail (proposed, not yet approved)

• Focus: gas and condensate

• Expected production: 1 – 1.5 billion cubic feet of gas per day and up to 290,000 barrels per day of condensate

• FPSO storage: up to 2 million barrels of condensate

• Offloading: every 3 – 5 days

• Wells: estimated 24 – 60

• Reservoirs: Longtail, Tripletail, Turbot discoveries (2017 – 2019)

• Production life: 30 years (planned)

• Location: easternmost offshore development

The Longtail-1 well was drilled by the Stena DrillMAX.
